Profitable Vendor Selection: A Guide for Energy Projects

929cb695-807b-4850-b536-42bda5dddee7

Profitable Vendor Selection: A Guide for Energy Projects

Introduction: Why Rigorous Vendor Selection is the Cornerstone of Profitable Energy Projects

The success of any capital-intensive energy project, from a utility-scale solar farm to an industrial microgrid, hinges on decisions made long before the first shovel hits the ground. Of these, vendor selection is arguably the most critical. A rigorous, data-driven selection process transcends simple procurement; it is a fundamental act of risk management and value creation. Choosing the right technology and partner ensures that a project not only gets built on time and on budget but also performs optimally throughout its 20-30 year lifespan, delivering the projected financial returns. In an industry defined by tight margins, complex integrations, and long-term operational commitments, treating vendor selection as a mere administrative task is a direct path to value destruction. Instead, viewing it as the cornerstone of project development establishes a foundation of technical reliability and financial viability that supports the entire investment.

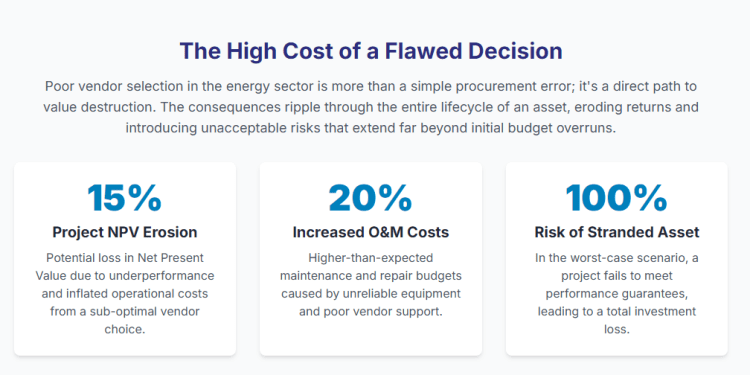

The High Cost of Poor Vendor Selection: Beyond Project Delays and Budget Overruns

The consequences of a flawed vendor selection process extend far beyond immediate schedule slips and cost overruns. A technically inferior or commercially unstable vendor can saddle an asset with a lifetime of underperformance. This manifests as lower-than-projected energy output, higher-than-expected degradation rates, and chronic operational issues that inflate maintenance budgets. These factors directly erode the project’s net present value (NPV) and internal rate of return (IRR). Furthermore, poor choices can lead to significant safety incidents, reputational damage, and costly disputes over warranty claims with a vendor who may lack the financial stability to honor them. In the worst-case scenario, a project becomes a stranded asset, unable to meet its performance guarantees or debt service covenants, leading to a total investment loss. The true cost is not just the initial price difference but the cumulative loss of revenue and escalation of expenses over the asset’s entire lifecycle.

Moving from a “Lowest Bid” to a “Best Value” Paradigm

The traditional procurement model, often driven by a “lowest bid wins” mentality, is profoundly ill-suited for complex energy assets. This approach fixates on minimizing initial capital expenditure (CapEx) while largely ignoring the far more significant lifecycle operational expenditures (OpEx), performance, and risk. The “Best Value” paradigm represents a strategic shift, evaluating vendors on a holistic basis. It acknowledges that a 10% higher CapEx for a system with 5% greater efficiency and 50% lower maintenance costs yields a vastly superior long-term return. This methodology, grounded in technoeconomic analysis, systematically weighs technical performance, lifecycle costs (LCOE/LCOS), reliability, and vendor stability against the initial price. It reframes procurement from a simple transaction to a strategic investment decision, ensuring the selected partner delivers the maximum risk-adjusted value over the project’s life, not just the cheapest price on closing day.

The Strategic Role of Technoeconomic Analysis (TEA) in De-risking Investments

Technoeconomic Analysis (TEA) is the formal methodology that powers the “Best Value” paradigm. It is a multi-disciplinary framework that translates complex technical specifications, performance data, and commercial terms into a clear financial forecast. By building sophisticated lifecycle cost models, TEA allows project stakeholders to compare disparate vendor proposals on a normalized, apples-to-apples basis, typically using metrics like Levelized Cost of Energy (LCOE), Net Present Value (NPV), and Internal Rate of Return (IRR). Its strategic role is to de-risk investment by quantifying the financial impact of technical choices. For example, TEA can model the revenue loss from a battery system with a lower round-trip efficiency or the increased OpEx from an inverter with a shorter service interval. This transforms abstract technical data into tangible financial outcomes, providing a defensible, data-driven foundation for making multi-million-dollar investment decisions and securing project financing.

Who This Guide Is For and What You Will Learn

This guide is written for the technical and financial professionals at the heart of energy project development and asset management. This includes project developers, procurement managers, energy engineers, financial analysts, and asset owners. Whether you are deploying your first battery storage system or commissioning your tenth solar plant, this guide provides a structured framework for enhancing your vendor selection process. You will learn how to move beyond simplistic price comparisons and implement a robust, technoeconomic evaluation methodology. This guide will walk you through establishing clear project goals, crafting a data-rich RFP, building a multi-criteria evaluation matrix, conducting rigorous technical and financial due diligence, and quantifying risk. By the end, you will be equipped to make more informed, defensible, and ultimately more profitable vendor selection decisions that maximize the lifecycle value of your energy assets.

The Foundation – Aligning Project Goals with Technoeconomic Criteria Pre-RFP

Defining Success: Establishing Key Performance Indicators (KPIs) for Your Project

Before engaging the market, you must first define what a successful outcome looks like in quantifiable terms. These Key Performance Indicators (KPIs) form the bedrock of your technoeconomic model and evaluation criteria. For a power generation project, primary KPIs might include the Levelized Cost of Energy (LCOE), plant availability (%), capacity factor (%), and specific fuel/energy consumption (kWh/unit). For an energy storage system, critical KPIs would be the Levelized Cost of Storage (LCOS), round-trip efficiency (%), warranted cycle life, and degradation rate (%/year). Financial KPIs such as Net Present Value (NPV), Internal Rate of Return (IRR), and payback period are universal. Establishing these targets upfront—e.g., “Achieve an LCOE below $50/MWh with 98% availability”—forces clarity of purpose and provides objective benchmarks against which all vendor proposals will be measured.

Stakeholder Alignment: Integrating Engineering, Operations, and Finance Perspectives

A successful vendor selection process is not the sole responsibility of the procurement department. It requires active collaboration and alignment between Engineering, Operations, and Finance. Each group holds a critical piece of the value puzzle. Engineering focuses on technical specifications, system efficiency, and reliability. Operations is concerned with long-term maintainability, spare parts availability, and ease of use. Finance scrutinizes the business case, focusing on CapEx, OpEx, NPV, and risk-adjusted returns. A formal pre-RFP alignment process, often through a series of workshops, is essential to reconcile competing priorities. The output of this process is a unified set of weighted evaluation criteria that reflects the organization’s holistic definition of “best value.” This prevents internal conflicts late in the selection process and ensures the chosen vendor satisfies the needs of the entire asset lifecycle.

Baseline Modeling: Understanding Your “Do Nothing” Scenario and Performance Targets

To justify any new investment, you must first have a clear and accurate understanding of your baseline. The “do nothing” or status quo scenario serves as the financial and operational benchmark against which all proposals are compared. For a facility considering a solar+storage system, the baseline is their current utility bill, including energy consumption (kWh) and demand charges (kW), projected forward with anticipated tariff escalations. This model establishes the economic “pain point” the project aims to solve. From this baseline, you can set clear performance targets. For instance, the goal might be to “reduce demand charges by 90% and overall electricity costs by 50%.” This baseline model is not a mere formality; it is the starting point for calculating the project’s value proposition (e.g., savings, revenue) and is a fundamental input for the NPV and IRR calculations for every vendor proposal.

Initial Market Sounding: Identifying Potential Vendors and Technology Classes

Before issuing a formal Request for Proposals (RFP), conducting an initial market sounding is a crucial de-risking step. This reconnaissance phase involves researching potential technology suppliers, integrators, and service providers to understand the current landscape. The goal is to identify the major players, understand the different technology classes available (e.g., lithium-ion vs. flow batteries; monocrystalline vs. bifacial solar panels), and gauge their relative maturity and bankability. This can be done through reviewing industry publications, attending conferences, and holding informal, exploratory discussions with potential suppliers. This process prevents the issuance of an overly narrow RFP tailored to a single technology or an unrealistic one with specifications that no vendor can meet. It ensures your subsequent RFP is well-informed, competitive, and targeted at a qualified pool of potential partners who can genuinely deliver on your project’s goals.

Building the Business Case: The Initial Go/No-Go Decision Framework

Armed with defined KPIs, stakeholder alignment, a baseline model, and initial market intelligence, the final foundational step is to build a preliminary business case. This high-level analysis uses estimated costs and performance data to determine if the project meets a minimum viability threshold, creating a crucial go/no-go decision gate before committing the significant resources required for a full RFP process. The framework should answer key questions: Does the project appear to meet our target IRR based on market-average cost data? Are there reputable vendors capable of meeting our core technical requirements? Are the potential returns sufficient to justify the project’s inherent risks? This initial screen acts as a filter, ensuring that only projects with a strong probability of financial and technical success proceed to the formal procurement stage. It’s a critical sanity check that conserves organizational resources for the most promising initiatives.

Crafting a Data-Driven RFP/RFQ for Superior Vendor Selection

The Anatomy of an Effective RFP/RFQ for Technical Systems

An effective Request for Proposal (RFP) or Request for Quote (RFQ) is a meticulously structured document designed to elicit clear, comparable, and comprehensive information. Its anatomy should include: 1) Project Overview and Objectives, stating the business goals and KPIs. 2) Scope of Work, detailing the required supply, installation, and commissioning services. 3) Technical Specifications, outlining the required performance and components. 4) Data Submission Requirements, mandating specific formats for technical and cost data. 5) Commercial Terms, including proposed contract structure, warranties, and performance guarantees. 6) Evaluation Criteria, transparently stating how proposals will be scored. 7) Submission Logistics, including deadlines and contact points. A well-constructed RFP functions as a precise instrument; it guides vendors to provide exactly the data you need for a rigorous technoeconomic evaluation, minimizing ambiguity and follow-up requests.

Mandating Standardized Submission Formats for Apples-to-Apples Comparison

This is arguably the most critical administrative element for enabling a robust technoeconomic analysis. Without it, you are left comparing proposals in wildly different formats, making objective evaluation nearly impossible. The RFP must include mandatory, pre-formatted spreadsheets (e.g., Excel templates) for vendors to complete. Key templates should include a detailed Cost Breakdown Sheet (separating hardware, software, labor, shipping, etc.), a Performance Data Sheet (for efficiency curves, degradation rates, etc.), and an O&M Schedule (detailing tasks, frequency, and costs). This forces all bidders to present their data in a uniform structure, allowing you to directly populate your evaluation matrix and financial models. Specialized energy project management platforms can streamline this; for example, after you sign up at https://jisenergy.com/sign-up-login/, you might find tools to deploy such standardized templates to manage vendor data collection efficiently, saving countless hours of manual data transposition and normalization.

Technical Specifications: Prescriptive vs. Performance-Based Approaches

When defining technical requirements, project owners face a choice between prescriptive and performance-based specifications. A prescriptive approach is directive, e.g., “The system shall use Brand X inverters and Tier-1, 550W bifacial solar modules.” This offers control and predictability but can stifle vendor innovation and may not result in the most cost-effective solution. A performance-based approach, in contrast, defines the desired outcome, e.g., “The system shall achieve a first-year performance ratio of 85% and a maximum degradation rate of 0.4% per year.” This encourages vendors to propose their most innovative and value-engineered solutions. Often, the best approach is a hybrid: prescribing critical, non-negotiable components (like safety systems) while allowing performance-based flexibility for major equipment where technological trade-offs exist. The choice depends on your organization’s technical expertise and risk appetite.

Requesting Key Data for Technoeconomic Modeling (Efficiency Curves, Degradation Rates, O&M Schedules)

To fuel your technoeconomic model, your RFP must demand specific, granular data—not just marketing-level specifications. Go beyond a single “peak efficiency” number and request full efficiency curves that show performance across a range of operating conditions (e.g., load, ambient temperature). For storage or generation assets, demand guaranteed degradation rates over the project’s life, backed by long-term testing data or studies. Require a detailed, multi-year O&M schedule that itemizes every planned maintenance activity, its frequency, required labor hours, and a list of necessary spare parts and consumables. This data is the lifeblood of your lifecycle cost analysis. Vague or missing data in a proposal is a significant red flag, indicating either a lack of sophistication or an attempt to obscure long-term costs.

(Source: National Renewable Energy Laboratory, nrel.gov)

Defining Contractual and Performance Guarantee Requirements Upfront

The RFP is the ideal place to establish your non-negotiable contractual and performance requirements. Clearly state the minimum acceptable levels for key guarantees. For example: “The proposal must include a 98% annual availability guarantee, with liquidated damages of $X per hour of downtime.” Or, “The battery system must come with a minimum 15-year warranty covering a throughput of 6,000 equivalent full cycles to a minimum 70% end-of-life capacity.” Stating these requirements upfront serves two purposes. First, it filters out vendors who are unwilling or unable to stand behind their product with meaningful commercial commitments. Second, it standardizes the risk profile of the proposals you receive, ensuring that the financial models for each vendor are based on a similar set of performance and warranty assumptions. This prevents a scenario where a low-cost bid is secretly propped up by weak or non-existent guarantees.

The Core of Technoeconomic Analysis – Developing a Multi-Criteria Vendor Selection Matrix

vendor selection evaluation criteria

Structuring Your Weighted Scoring Matrix: Categories and Sub-categories

The weighted scoring matrix is the central tool for translating your evaluation into a defensible decision. It provides a structured, transparent framework for comparing vendors. The matrix is typically organized into three to four high-level categories: Technical, Economic, and Commercial/Risk. Each of these categories is then broken down into specific, measurable sub-categories. For instance, the “Technical” category might include sub-categories like “System Efficiency,” “Reliability (MTBF),” and “Interoperability.” This hierarchical structure ensures that all critical aspects of the project are considered systematically. By assigning a score to each sub-category for every vendor, you create a detailed performance profile that moves beyond a single price point and facilitates a holistic, side-by-side comparison of the competing proposals.

Technical Evaluation Criteria (System Performance, Efficiency, Reliability, Integration)

The technical evaluation section of your matrix quantifies the “techno” part of your analysis. It assesses how well the proposed solution will perform its intended function. Key criteria include:

  • Performance & Efficiency: This goes beyond nameplate ratings. For a battery, it’s round-trip efficiency and response time. For a generator, it’s the heat rate or fuel efficiency curve. These are scored based on the detailed data requested in the RFP.
  • Reliability & Durability: This is evaluated using metrics like Mean Time Between Failures (MTBF) for key components, warranted degradation rates, and the design life of the system.
  • Technology Maturity: Assesses the provenness of the proposed technology, often using a Technology Readiness Level (TRL) scale.
  • Integration & Interoperability: Scores the vendor’s plan and demonstrated ability to integrate their system seamlessly with your existing infrastructure (e.g., SCADA, building management systems).

Economic Evaluation Criteria (CapEx, OpEx, LCOE/LCOS, NPV, IRR, Payback Period)

This section of the matrix translates all technical and commercial data into financial outcomes. It is the quantitative core of the “best value” assessment.

  • Capital Expenditure (CapEx): The “all-in” installed cost, broken down into hardware, software, and services as per the standardized submission format. A lower CapEx receives a higher score.
  • Operational Expenditure (OpEx): The modeled lifecycle cost, including scheduled maintenance, unscheduled repairs, consumables, and any software subscription fees. Lower projected OpEx receives a higher score.
  • Levelized Cost of Energy/Storage (LCOE/LCOS): This is a critical lifecycle metric that normalizes total costs over total energy output/throughput. It provides the single best apples-to-apples unit cost comparison. (Source: Lazard, lazard.com)
  • NPV, IRR, and Payback Period: These core financial metrics are calculated for each vendor’s proposal using a standardized discounted cash flow (DCF) model. They measure the overall financial attractiveness of the investment, with higher NPV/IRR values receiving higher scores.

Commercial and Risk Evaluation Criteria (Company Viability, Warranty, Project Team, Safety Record)

This category assesses the vendor as a long-term partner and evaluates factors that mitigate project risk. It’s crucial for ensuring the vendor can deliver on their promises and support the asset over its lifetime.

  • Company Viability: Assesses the vendor’s financial health (e.g., using Dun & Bradstreet reports), time in business, and supply chain stability. A strong, stable company is a lower-risk partner.
  • Warranty and Guarantees: Scores the strength, duration, and clarity of the offered warranties and performance guarantees. A comprehensive warranty with clear terms and strong remedies for non-performance receives a high score.
  • Project Team & Experience: Evaluates the qualifications and track record of the proposed project management and engineering team. Relevant project references are critical here.
  • Safety Record: Examines the vendor’s documented safety performance, typically through metrics like their Experience Modification Rate (EMR) or Total Recordable Incident Rate (TRIR). A strong safety culture is non-negotiable.

Assigning Weights: Reflecting Project Priorities in Your Scoring System

Assigning weights to each category and sub-category is the step that tailors the evaluation matrix to your specific project’s priorities. This is where the stakeholder alignment achieved in Section 1 becomes critical. A project with a primary goal of maximizing long-term financial return might assign a 40% weight to the Economic category, 30% to Technical, and 30% to Commercial/Risk. Conversely, a mission-critical facility like a hospital or data center might place a higher weight on the Technical (e.g., 40%) and Commercial/Risk (e.g., 35%) categories to prioritize reliability and vendor stability, with the Economic category receiving a lower weight (e.g., 25%). The weights must be agreed upon by all stakeholders before the proposals are evaluated to ensure objectivity. This process makes the final decision transparent and defensible, clearly showing how the winning vendor’s proposal best aligned with the project’s stated strategic objectives.

Technical Due Diligence and Performance Verification

Beyond the Brochure: Scrutinizing Technical Submittals and Data Sheets

The data provided in a vendor’s proposal is a claim, not a fact, until verified. Technical due diligence begins with a deep, critical review of all submitted documents. This means moving beyond the glossy marketing brochures and scrutinizing the detailed technical data sheets, single-line diagrams, and component specification sheets. Check for internal consistency. Do the component efficiencies claimed in one document align with the overall system efficiency guaranteed elsewhere? Are the physical dimensions and weights practical for your site? Question any ambiguous or “typical” values and demand guaranteed minimum/maximum performance data. This detailed paper-based review is the first line of defense against exaggerated marketing claims and is essential for identifying potential design flaws or component mismatches before they become construction-stage problems. It’s a meticulous process of cross-referencing and questioning every technical assertion.

Validating Performance Claims: Cross-Referencing with Independent Data and Factory Acceptance Test (FAT) Procedures

To validate a vendor’s performance claims, it’s crucial to seek external, independent verification. Do not rely solely on the vendor’s own data. Cross-reference their claimed equipment performance (e.g., solar panel efficiency, battery degradation) with independent third-party testing reports from recognized labs like PVEL (PV Evolution Labs) or DNV. For newer technologies, consult public data from research institutions. Furthermore, the proposal must include a detailed Factory Acceptance Test (FAT) and Site Acceptance Test (SAT) procedure. Review these procedures carefully. Do they adequately test the key performance parameters under realistic conditions? A robust FAT/SAT plan is a strong indicator of a quality-focused vendor. It provides a contractual mechanism to verify that the equipment you paid for performs as promised before it is shipped to your site and before you make final payment.

Assessing Technology Maturity and Deployment Risk (TRL/MRL)

Evaluating the maturity of the proposed technology is a critical risk management step, especially when considering novel solutions. The Technology Readiness Level (TRL) scale, originally developed by NASA and widely adopted, is an excellent framework for this assessment. TRL 1-3 represents early-stage R&D, while TRL 8-9 signifies a fully proven, commercially deployed system. For capital-intensive energy projects requiring financing, technologies should typically be at TRL 8 or higher. Similarly, the Manufacturing Readiness Level (MRL) scale assesses the maturity of the vendor’s production capabilities, gauging their ability to produce the technology reliably, at scale, and with consistent quality. A low MRL can signal potential for production delays and quality control issues. Requesting that vendors state the TRL/MRL of their core components and providing evidence helps quantify the technology risk associated with their proposal.

(Source: U.S. Department of Energy, energy.gov)

Evaluating Interoperability and Integration with Existing Systems (SCADA, BMS)

A state-of-the-art energy asset that cannot communicate with your existing control systems is of little value. Technical due diligence must rigorously assess the proposed system’s interoperability. This requires a detailed review of the vendor’s control and communication architecture. Do they use open, standard protocols like Modbus TCP, DNP3, or OPC UA, or are they proposing a proprietary “black box” system that will be difficult to integrate and maintain? The vendor should provide a clear integration plan, detailing how their controller or gateway will interface with your master SCADA (Supervisory Control and Data Acquisition) system or Building Management System (BMS). It is wise to involve your own control systems engineers or a third-party expert in this review. Verifying this a priori prevents costly and time-consuming integration challenges during the commissioning phase, which are a common source of project delays.

Conducting Reference Checks and Site Visits: Verifying Real-World Performance

No amount of paper-based review can replace the value of seeing a technology in action and speaking with those who operate it. Conducting thorough reference checks is non-negotiable. Request a list of clients with similar systems and have candid conversations with their plant managers and engineers. Ask about the reality of the system’s performance versus what was promised. Inquire about the vendor’s responsiveness during commissioning and for post-sales support. Were there unexpected maintenance issues? How accurate was the O&M budget? Whenever possible, supplement these checks with a site visit to an operational facility. A site visit allows you to observe the equipment’s build quality, noise levels, and physical footprint firsthand. It provides invaluable, real-world context that can either validate or challenge the claims made in the vendor’s proposal, offering a final, crucial layer of due diligence.

Financial Modeling for Lifecycle Value: Moving Beyond CapEx in Vendor Selection

vendor selection lifecycle cost analysis

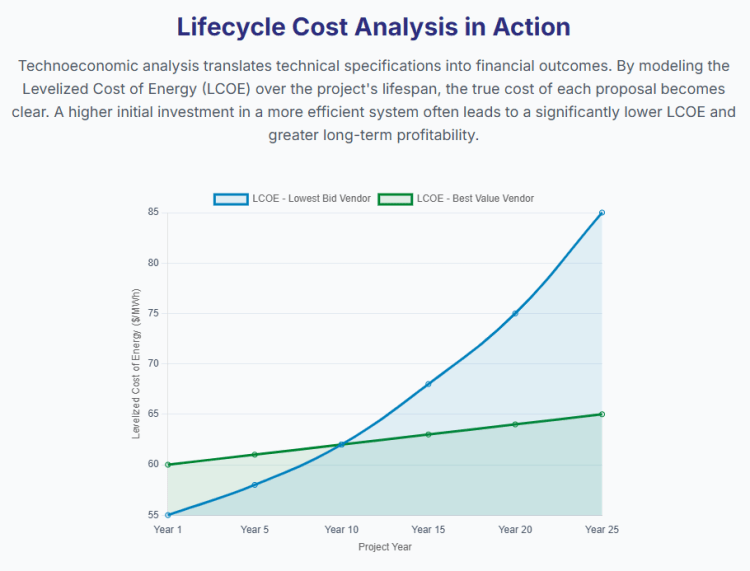

Building a Robust Lifecycle Cost Analysis (LCCA) Model

A robust Lifecycle Cost Analysis (LCCA) model is the engine of your economic evaluation. It moves the focus from a one-time purchase price to the total cost of owning and operating the asset over its entire economic life. The LCCA model must be structured to capture all relevant cash flows, typically on an annual basis for 20-30 years. Key inputs on the cost side include the initial CapEx, planned O&M costs, unscheduled maintenance provisions, component replacement costs (e.g., inverter replacement in year 12), insurance, and any end-of-life decommissioning costs. On the revenue or savings side, it includes energy sales, avoided utility costs, ancillary service revenues, and tax incentives. This comprehensive model, when applied consistently to each vendor’s data, provides the foundation for calculating key financial metrics like NPV and LCOE, enabling a true “best value” comparison.

Modeling Operational Costs: Energy Consumption, Maintenance, Consumables, and Labor

Accurately modeling OpEx is what separates a superficial analysis from a rigorous one. This requires breaking down operational costs into specific components using the detailed data requested in the RFP.

  • Energy Consumption: Model parasitic loads—the energy consumed by the system itself for cooling, controls, and standby power. A system with lower parasitic loads will have a better net energy output.
  • Maintenance: Differentiate between planned and unplanned maintenance. Model the annual cost of service contracts and planned maintenance activities based on the vendor’s provided schedule and labor rates. Add a contingency (e.g., 1-2% of CapEx annually) for unplanned repairs not covered by warranty.
  • Consumables and Spares: Quantify the cost of items that must be replaced regularly, such as filters, fluids, or other consumables. Factor in the cost of holding critical spare parts on-site.
  • Labor: Estimate the internal labor hours required for routine checks and operation, translating this into a cost for your organization.

Quantifying Revenue Streams or Savings (Energy Arbitrage, Demand Charge Reduction, Production Credits)

The value proposition of an energy project is realized through the revenue it generates or the costs it avoids. Your financial model must accurately quantify these streams. For a utility-scale project, this is primarily revenue from energy sales under a Power Purchase Agreement (PPA). For a behind-the-meter battery system, the value is more complex and may involve multiple “stacked” applications:

  • Demand Charge Reduction: Modeling the system’s ability to “peak shave” and reduce the facility’s monthly demand (kW) charges.
  • Energy Arbitrage: Calculating the savings from charging the battery during off-peak, low-cost hours and discharging during on-peak, high-cost hours.
  • Ancillary Services: Quantifying potential revenue from participating in grid service programs like frequency regulation, if applicable.
  • Production Credits: Including the value of any applicable tax credits (like the ITC/PTC) or renewable energy certificates (RECs). Each vendor’s technical capabilities (e.g., efficiency, response time) will directly impact their ability to capture these value streams.

Sensitivity and Scenario Analysis: Stress-Testing Vendor Proposals Against Market Volatility (Fuel Prices, Electricity Tariffs)

A static financial model based on a single set of assumptions is brittle. The real world is volatile. Sensitivity and scenario analysis are essential for stress-testing vendor proposals and understanding which one is most resilient to future uncertainty.

  • Sensitivity Analysis: Varies a single key input (e.g., future electricity price, fuel cost, degradation rate) within a plausible range to see how it impacts the project’s NPV or IRR. This can reveal, for example, that a more efficient but higher-CapEx system becomes vastly superior if electricity prices rise more than expected.
  • Scenario Analysis: Combines multiple variables to create different future “scenarios” (e.g., a “High Commodity Cost” scenario, a “Low Renewable Penetration” scenario). Comparing how each vendor’s proposal performs across these scenarios provides deep insight into their risk-adjusted value. This process often highlights that the “lowest CapEx” option is also the most vulnerable to market shifts.

Comparing Different Financial Structures (Direct Purchase vs. PPA vs. EaaS) in Your Vendor Selection

Modern energy procurement is not limited to direct purchase. Vendors may offer alternative commercial models that need to be compared on a level playing field using your technoeconomic framework.

  • Direct Purchase: The traditional model where the organization owns and operates the asset. The LCCA model is based on full CapEx and OpEx.
  • Power Purchase Agreement (PPA): A third party owns and operates the asset on your site, and you agree to purchase the energy at a fixed rate ($/kWh) for a long term. The comparison involves modeling your total payments under the PPA versus the lifecycle costs and benefits of direct ownership.
  • Energy-as-a-Service (EaaS): A broader service model where the vendor provides an energy outcome (e.g., “resilience” or “cost savings”) for a recurring fee, with no upfront CapEx. The evaluation compares the total EaaS fees over the contract term to the NPV of a self-owned project.

Your TEA model must be flexible enough to evaluate these different cash flow structures and determine which offers the best financial value for your organization’s specific capital constraints and risk appetite.

(Source: Deloitte, deloitte.com)

Quantifying the Unquantifiable – Risk and Intangible Factors in Vendor Selection

Vendor Viability Assessment: Financial Health, Supply Chain Stability, and Longevity

A 25-year performance warranty is worthless if the vendor goes out of business in year five. Assessing vendor viability is a critical risk mitigation step. This goes beyond a simple credit check. The evaluation should include a thorough review of the vendor’s financial statements (if public) or third-party financial stability reports (like those from Dun & Bradstreet) to assess their profitability, debt load, and cash flow. Inquire about their supply chain strategy: Are they single-sourced for critical components? How have they managed recent global supply chain disruptions? Consider their longevity and track record. A well-established company with a large installed base and a history of honoring warranties represents a significantly lower long-term risk than a new entrant with a limited track record, even if their price is lower. This assessment can be scored on a 1-5 scale in your matrix.

Evaluating the Proposed Project Team and Implementation Plan

The quality of the team executing the project is as important as the quality of the technology itself. Your evaluation must scrutinize the vendor’s proposed project team and their implementation plan. Request the CVs of the key personnel who will be assigned to your project—the project manager, lead engineer, and site supervisor. Do they have direct, demonstrable experience with projects of similar scale and complexity? The project implementation plan should be detailed and credible. Look for a well-defined schedule with clear milestones, a robust safety plan, a quality assurance/quality control (QA/QC) process, and a clear communication and reporting structure. A vague or generic plan is a red flag, suggesting a lack of preparation or experience. This can be scored by assessing the plan’s detail, credibility, and the team’s combined years of relevant experience.

Assessing the Quality of Warranties, Performance Guarantees, and Service Level Agreements (SLAs)

Not all warranties and guarantees are created equal. It is crucial to read the fine print and score the quality and comprehensiveness of these commercial protections. Key questions to ask include:

  • Warranty: What is covered (parts, labor, shipping)? What are the exclusions? Is the remedy “repair or replace” at the vendor’s discretion? How complex is the claims process? A comprehensive, bumper-to-bumper warranty scores higher.
  • Performance Guarantees: How is performance measured? What is the cure period if the system underperforms? Are the liquidated damages (LDs) meaningful enough to compensate for lost revenue, or are they capped at a trivial amount?
  • Service Level Agreements (SLAs): For any long-term service contract, what are the guaranteed response times for technical support and on-site service? What are the penalties for failing to meet these SLAs?

A proposal with strong, clear, and commercially meaningful protections receives a high score in this category.

De-risking Your Project: How a Strong Vendor Selection Mitigates Construction and Operational Risk

A rigorous vendor selection process is one of the most effective tools for de-risking a project. By choosing a vendor with a proven track record, a strong balance sheet, and a robust safety program, you inherently mitigate construction risk. Such a vendor is more likely to manage the project effectively, adhere to schedules, and handle unforeseen challenges without compromising quality or safety. They are also less likely to cause delays due to financial instability or supply chain issues. On the operational side, selecting a vendor with reliable technology, a comprehensive warranty, and a responsive service organization directly reduces operational risk. This translates into higher asset availability, lower-than-expected maintenance costs, and a greater certainty of achieving the projected financial returns over the project’s lifetime, making the project more attractive to investors and lenders.

Scoring Intangibles: A Framework for Evaluating Vendor Responsiveness and Partnership Potential

While most criteria can be quantified, some valuable attributes are intangible. However, they can still be scored systematically. Create a rubric for evaluating factors that indicate a vendor’s quality as a long-term partner.

  • Responsiveness and Clarity (Pre-Award): Score vendors on the quality and timeliness of their responses to your RFP questions. Were their answers clear, direct, and comprehensive, or were they evasive and generic? A responsive vendor is more likely to be a good partner post-award.
  • Cultural Fit and Collaboration: During clarification meetings and interviews, assess the vendor’s team. Do they listen to your needs? Are they collaborative problem-solvers or do they take a rigid, transactional approach?
  • Innovation and Future-Proofing: Does the vendor demonstrate a forward-looking approach to technology, such as offering a clear software upgrade path or a modular design that allows for future expansion?

These factors can be scored on a simple 1-5 scale by the evaluation committee, providing a structured way to incorporate crucial “soft” data into the final decision.

Case Study – Technoeconomic Vendor Selection for a Commercial BESS Installation

Project Overview: 2 MW / 4 MWh Battery Energy Storage System for a Manufacturing Facility

The project’s objective was to install a 2 MW / 4 MWh behind-the-meter Battery Energy Storage System (BESS) at a manufacturing facility. The primary goals were to reduce high electricity demand charges, which occurred during afternoon production peaks, and to participate in a local utility’s demand response program for additional revenue. Key KPIs established were a payback period of under 7 years, a minimum round-trip efficiency of 88%, and a warranted capacity of at least 70% after 15 years. The project team, comprising engineering, finance, and operations, weighted the evaluation criteria as 40% Economic, 35% Technical, and 25% Commercial/Risk, reflecting a strong focus on financial return while maintaining high technical and reliability standards for the mission-critical facility.

The Evaluation Matrix in Action: Comparing Three Distinct Vendor Proposals

The RFP process yielded three distinct proposals, which were entered into the weighted scoring matrix.

  • Vendor A: Offered the lowest CapEx by using lower-cost, Tier-2 LFP cells and a basic Energy Management System (EMS). Their proposal scored highest on the initial CapEx metric.
  • Vendor B: Proposed a premium solution with a 15% higher CapEx, using Tier-1, high-cycle-life NMC cells from a top-tier manufacturer and an advanced, AI-powered EMS designed to optimize both demand charge reduction and demand response revenue.
  • Vendor C: Offered an Energy-as-a-Service (EaaS) model with zero CapEx. The facility would pay a fixed monthly fee for 15 years in exchange for guaranteed demand charge savings and a share of the demand response revenue.

Vendor A (Low CapEx, Tier-2 Cells) vs. Vendor B (High CapEx, Tier-1 with Advanced EMS) vs. Vendor C (EaaS Model)

The initial comparison was stark. Vendor A was the cheapest upfront. Vendor B was the most expensive but promised superior performance and longevity. Vendor C eliminated the capital hurdle entirely. The TEA model revealed the underlying value. Vendor A’s lower-cost cells had a higher degradation rate and a lower warranted round-trip efficiency, which significantly reduced projected savings in the outer years of the financial model. Vendor B’s premium components and advanced EMS showed a 4% higher net efficiency and slower degradation, leading to a much stronger NPV despite the higher initial cost. Vendor C’s EaaS model was attractive for its simplicity and lack of upfront investment, but the total payments over 15 years resulted in the lowest overall NPV for the facility, as the vendor retained a significant portion of the project’s value.

The Decisive Role of Lifecycle Cost and Performance Degradation Modeling

The deciding factor between Vendor A and Vendor B was the rigorous modeling of lifecycle costs and performance degradation. The TEA model projected that by year 8, Vendor A’s system would have degraded to the point where it could no longer fully eliminate the peak demand charge, and its lower efficiency meant higher charging costs. Vendor B’s system, while more expensive initially, was projected to maintain its performance well beyond year 10, consistently delivering the target savings. When these factors were translated into a 15-year discounted cash flow analysis, Vendor B’s proposal yielded an NPV that was 25% higher than Vendor A’s. This demonstrated unequivocally that Vendor A’s low CapEx was a false economy, masking higher long-term costs and lower long-term value.

How Sensitivity Analysis on Future Electricity Tariffs Influenced the Final Vendor Selection

To further validate the decision, a sensitivity analysis was performed on future electricity tariffs. A scenario was modeled where the utility’s demand charges increased by 5% annually instead of the baseline assumption of 2%. In this “High Tariff” scenario, the financial penalty for Vendor A’s underperformance in later years became even more severe, dramatically widening the NPV gap between Vendor A and Vendor B. Furthermore, the advanced EMS from Vendor B demonstrated a greater ability to co-optimize and capture more value as the tariff structures became more complex. This stress test solidified the choice of Vendor B, proving its solution was not only higher-performing but also more resilient to future market volatility, making it the clear “best value” choice despite the higher initial investment.

Lessons Learned: The Critical Importance of a Robust Software and Integration Plan

A key lesson from the case study was the underappreciated value of the Energy Management System (EMS) and the vendor’s integration plan. Initially viewed as a secondary component, the analysis revealed the EMS was the “brain” of the BESS, directly responsible for monetizing the asset. Vendor B’s superior AI-driven software could more accurately predict the facility’s load and optimize dispatch, capturing an estimated 5-7% more value annually than Vendor A’s simpler, rules-based EMS. Furthermore, Vendor B provided a detailed and credible plan for integrating with the facility’s existing control systems, which gave the operations team high confidence in a smooth commissioning process. The case underscored that for complex assets like a BESS, the quality of the software and the integration support are as critical as the hardware itself.

Conclusion: Institutionalizing Technoeconomic Rigor for Future Success

Recap: The Core Tenets of a Defensible Vendor Selection Process

A defensible, value-driven vendor selection process is built on a foundation of analytical rigor and strategic alignment. The core tenets are: 1) Define success first through clear, quantifiable KPIs agreed upon by all stakeholders. 2) Craft a data-driven RFP that compels vendors to provide standardized, comparable data. 3) Utilize a weighted, multi-criteria evaluation matrix to move beyond price and assess technical, economic, and commercial factors holistically. 4) Conduct deep due diligence to verify all vendor claims, from performance data to team experience. 5) Center the financial evaluation on a robust lifecycle cost analysis (LCCA) and stress-test the results with sensitivity analysis. Adhering to these principles transforms procurement from a tactical cost-cutting exercise into a strategic value-creation engine, ensuring that every project is built on a foundation of quality, reliability, and long-term profitability.

The Future of Vendor Selection: Leveraging AI and Digital Twins for Predictive Analysis

The principles of technoeconomic analysis will remain constant, but the tools are evolving. The future of vendor selection will be increasingly shaped by advanced analytics. Artificial intelligence (AI) and machine learning algorithms will be used to run thousands of sensitivity scenarios automatically, providing a probabilistic range of outcomes (e.g., a Monte Carlo simulation) rather than a single deterministic NPV. Furthermore, the concept of a “digital twin” will become central to the evaluation process. Project developers will be able to take a vendor’s proposed equipment specifications and build a virtual model of the asset. This digital twin can then be used to simulate a full year of operation against real-world weather and load data, providing a highly accurate, pre-construction forecast of performance. This will allow for an even more precise, predictive comparison of vendor proposals before a single dollar of capital is spent.

Building a Culture of Value-Based Procurement Within Your Organization

Implementing a TEA framework is not just about adopting a new spreadsheet; it’s about fostering a cultural shift within the organization. This requires moving away from siloed decision-making and departmental incentives that prioritize minimizing individual budgets (like a procurement team focused only on CapEx). Leadership must champion the “best value” and Total Cost of Ownership (TCO) philosophy. This involves creating cross-functional evaluation teams (engineering, finance, operations, procurement) and rewarding them based on the long-term success of the project, not on short-term cost savings. Training is essential to ensure all stakeholders understand the principles of lifecycle cost analysis and their role in the process. When an entire organization begins to speak the common language of risk-adjusted lifecycle value, it unlocks a powerful competitive advantage, ensuring capital is consistently deployed to the most productive and profitable projects.

Final Thoughts: From Transactional Procurement to Strategic Partnership Development

Ultimately, a world-class vendor selection process reframes the entire endeavor. It ceases to be a one-time, transactional purchase and becomes the first step in developing a long-term, strategic partnership. The energy assets being procured today are complex systems that will operate for decades, requiring ongoing support, software updates, and collaboration to maximize value. The technoeconomic framework detailed in this guide does more than just identify the proposal with the best numbers; it identifies the partner with the technical prowess, commercial stability, and collaborative mindset most likely to ensure the project’s success over its entire lifecycle. By investing the time and resources into this rigorous front-end process, organizations do not merely buy a piece of equipment; they secure a foundational partnership for future profitability and growth.
